1.PROJECT BACKGROUND

Miragoâne Grouting Case : There were two high-rise SRC buildings in a large-scale hillside development project. Four basements were fully excavated, and the foundation was situated on highly permeable rocky stratum.

sitio de citas chile During construction, due to the high water level at the rocky stratum under the foundation and the upper slope, the base water pressure was greater than 150kPa, and a large amount of water inrush (about 58m3/day) occurred at the raft base slab.

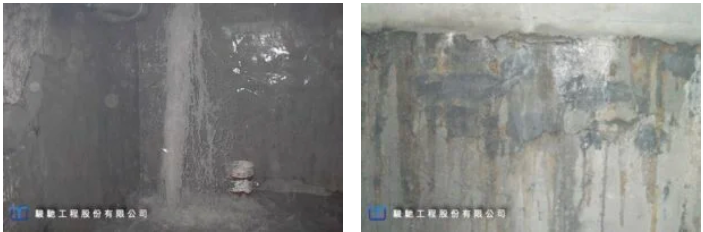

Groundwater even leaked into the basement of B4 floor through the steel structure column and concrete connection surface, which seriously affected the safety and function.



Grouting嚴重影響使用安全及功能













2. SOLUTION

In order to take into account, the quality of the project, the developers specially convened well-known experts and construction companies at home and abroad to discuss countermeasures and conduct on-site trials.

Due to the large pores of the rocky stratum under the foundation and the groundwater flow on the hillside, it was not easy to form cement-based quick-setting grout. In the end, the hot bitumen injection method was selected for raft foundation treatment as having the best leak-stop effect and would not be washed away by the inrush water.

熱瀝青灌注方式熱瀝青灌注方式













3. WORKS DESIGN

The location of the defect in the raft base slab was uncertain, and the accumulation of water in the water tanks made it difficult to perform non-destructive testing.

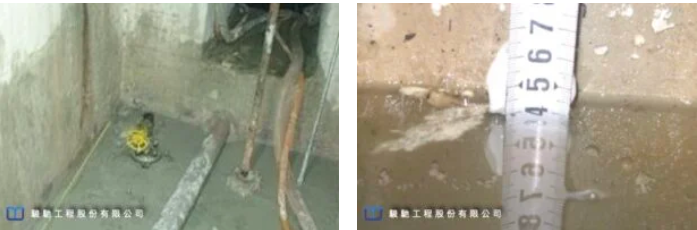

The company specially developed a compressed air detection method, which used observation of the location and scale of water inrush and the emergence of bubbles to define the fractured area.

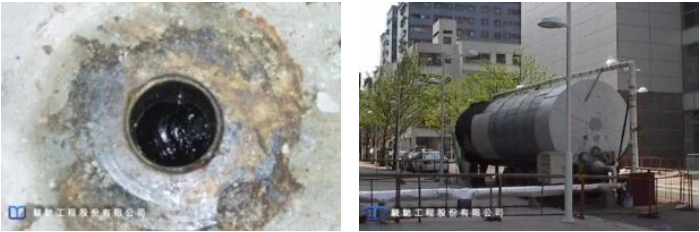

After inspection, it was found that the inrush channel was mainly concentrated at the column pile and foundation slab contact positions.

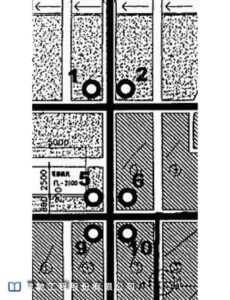

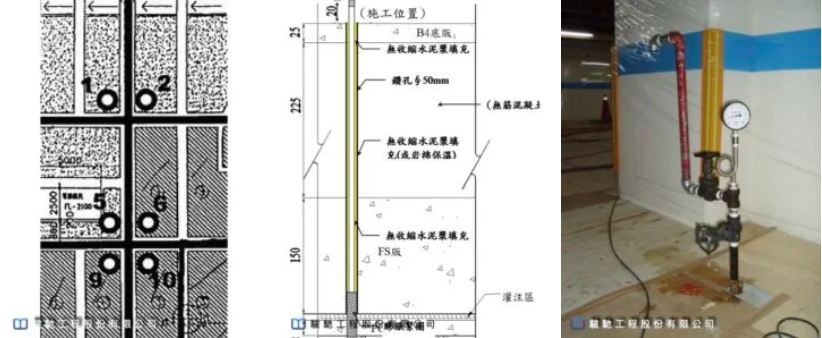

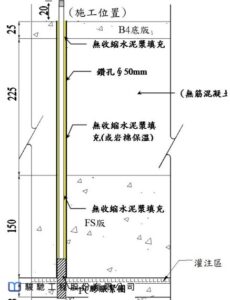

In the design, in order to overcome the partitioning of the foundation slab by the sewage tank, the fire-fighting water tank and the elevator shaft, the cross-beam staggered hot bitumen grouting method was specially adopted.

The method of skip hole grouting and overflow hole reverse grouting ensures that the gaps in the concrete and rocky layer covered by the column piles are completely filled with hot asphalt.

壓氣式檢測法湧水通路主要集中在立柱樁與基礎版連接位置











特採用跨地樑交錯式熱瀝青注漿法,以跳孔注漿、溢漿孔反向灌注方式設計圖Grouting

















4. WORKS PROCESS

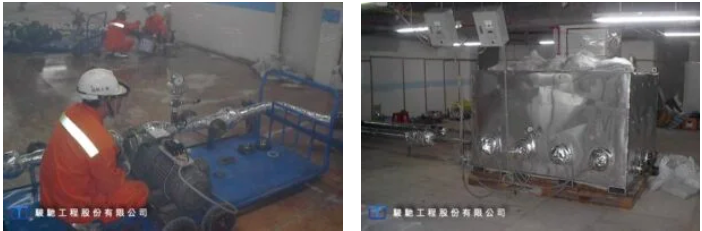

When a large amount of water inrush occurred in this building project, the basement structure had almost been completed, so the working space was extremely limited. Under the conditions of not damaging the main structure and having to work in the water tank, our company specially made all equipment miniaturized and modularized to meet operational requirements.

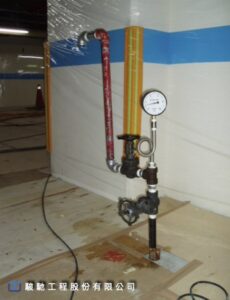

During the works, first a small perforator was used to carry out the lead holes of the concrete base plate and the basement floor plate, and to install the water stop valve and outer casing pipe. Next the hot bitumen grouting pipe, equipped with a plug was inserted into the casing, and the grouting operation was carried out per design procedure

Grouting安裝止水箱、外套管











5.  RESULTS

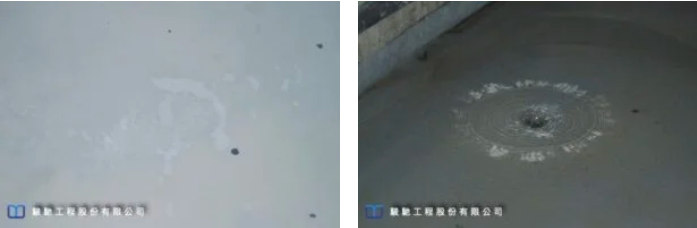

After each column base in the foundation was grouted with hot bitumen, the water leaking along the column position to the basement stopped immediately.

After the grouting of all holes was completed according to the design, the water inrush stopped completely. Only small-scale water seepage existed around the function tanks that could not be entered for grouting.

After long-term observation, the repaired raft base slab seepage rate (<3m3/day) was much lower than the original design pump load capacity and contract requirements, and the raft slab inrush repair work had been successfully achieved.

交錯式基底熱瀝青注漿修復後的筏基底版滲水量(<3m3/day)遠低於原設計抽水泵負載容量及合約要求
